New Building Update: January 19, 2026

Construction Progress and Updates

  • Electrical service is wired in basement but no power from overhead lines yet. DTE is scheduled to connect the lines the week of January 19th. (correction from last update)
  • Window installation is complete.
  • Main door installation is complete.
  • Planned to complete side and rear doors next week (week of January 19th).

Committee Tasks

  • TLN has been contacted to coordinate building electrical and data wiring. Follow-ups will continue to coordinate additional conduit and raceways needed for library operations.
  • Need to provide inner wall bracing height to contractor for shelve installation bracing.
  • Coordinate transportation of reclaimed doors once building is fully sealed in with masonry and windows.
  • Work with South East Commercial on interior finishes.
  • Review potential options for exterior signage on the building (“Addison Township Public Library” sign) shown below.

Download Construction Progress Update 17JAN26

New Building Update: October 23, 2025

Construction Progress

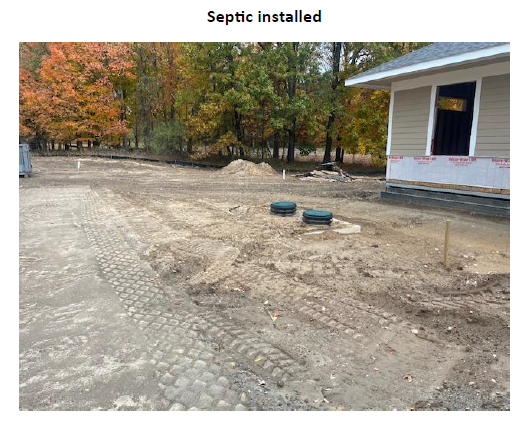

  • Septic is installed and inspections have been completed with approval.
  • Engraved bricks for building have arrived. Non-engraved bricks are due to arrive next week (around 10/28/2025).

  • Roofing is complete.

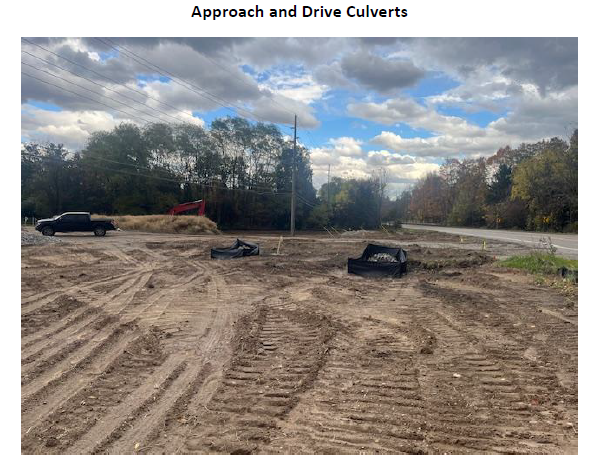

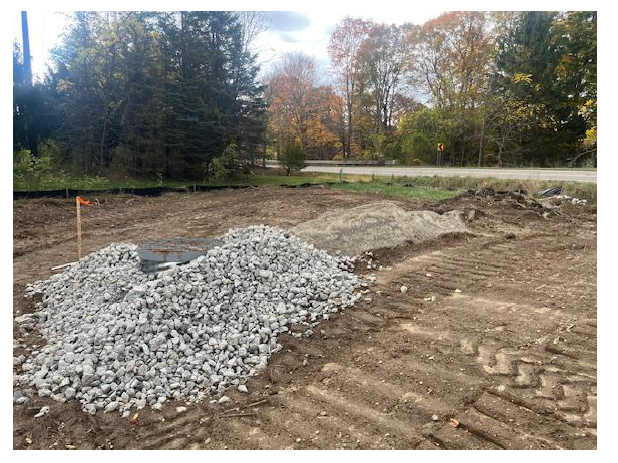

  • Underground culverts installed and inspections have been completed with approval.
  • Overflow structure for retention pond has been installed (Riser, Base and flow piping). Inspections completed and approved.
  • Underground conduit for electrical and communication wires from over head lines have been installed (parking lot lights, potential future sign, main line into building and extra conduit for communication lines)
  • Building exterior trim complete. Shop drawings for windows have been reviewed by contractor and approved. Windows ordered and due to be installed mid-November.

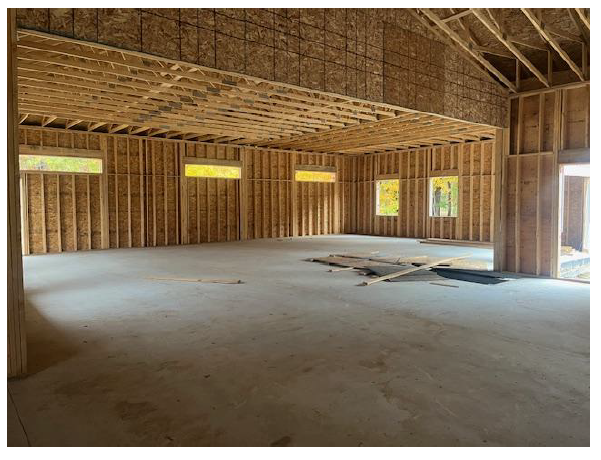

  • Material for interior walls has been delivered on site.
  • Currently planning the installation of gas line.
  • After gas line installation, drive approach and first stage of parking lot paving will begin.

New Building Update :: 9/16/2025

Construction Progress
– Exterior rough framing completed. Interior framing to start once roof is complete and building sealed (windows/doors)
– Truss and Roof construction complete.
– Staircase for basement installed and concrete steps poured.
– Non-engraved bricks for building are ordered and planned to begin exterior masonry in about 4-5 weeks. Working though bids to select contractor. Exterior brick selection is available for review.
– Engraved bricks have been ordered.
– Roof sheeting complete and shingling is expected to start next week (Sep. 22nd)

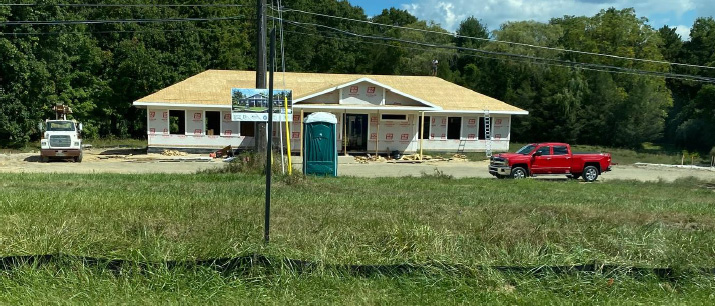

– Building exterior for siding and windows trim in progress. Expected to complete by end of next week.
– Working on securing source for Windows/doors. (selection and delivery in next 4weeks)
– Power Line installation date note yet planned. Working on securing electrician.
– Plumbing contractor is secured. Will begin work after roof completed.
– Continued site work and piping will go over next few weeks.

Committee Tasks
– TLN has been contacted to coordinate building electrical and data wiring with TLN. Follow-ups will continue to coordinate additional conduit and raceways needed for library operations.
– Need to provide inner wall bracing height to contractor for shelve installation bracing.
– Reclaimed doors have been reviewed by the contractor. Doors in good shape and will be used for interior doors.
– Work with South East Commercial on interior finishes.
– Review potential options for exterior signage on the building (“Addison Township Public
Library” sign) shown below.

CONSTRUCTION UPDATE: Backfilling the Site

Crews are onsite this week moving fill and bringing in fill to go around the basement walls.
